Work plan
Deadlines
2015-03-02 Choose a project proposal and send the result via email to epsatisep@gmail.com
2015-03-11 Define the Tasks (what must be done), Task allocation (who does what) and Gantt chart (when) of the project and insert them on the wiki (planning)
2015-03-27 Specify the list of material (what, quantity, where to buy - local companies are mandatory) on the wiki
2015-04-05 Upload the Interim Report and Presentation to the wiki; the report should contain the Introduction, including the tasks, team members allocation and Gantt chart, State of the Art, Marketing Plan, Project Management, Eco-eficiency Measures for Sustainability, Ethical and Deontological Concerns, Proposed Solution and Bibliography chapters
2015-04-09 Interim Presentation, Discussion and Assessment
2015-06-12 Upload the Final Report, Presentation, Video, Paper, Poster and Manual
2015-06-18 Final Presentation, Individual Discussion and Assessment
2015-06-25:
Update the wiki with all correction suggestions
Hand in a CD with the corrected deliverables (source + PDF) together with all code produced to the EPS coordinator
Hand in one printed exemplar of the corrected report to the EPS coordinator
2015-06-26:
Hand in the prototype and user manual to the client
Receive the EPS@ISEP certificate
Tasks
| Task | Responsible |
| meetings | all |
| plannings | all |
| research |
| material | Paloma |
| technologies | Bartek, Eughan |
| identity | Anthony |
| life-cycle | all |
| requirements | all |
| target | all |
| brief |
| identity | Anthony |
| objectives | all |
| implementation |
| marketing | Carina |
| materials | Paloma, Eughan, Bartek |
| programming | Eughan, Bartek |
| construction | Paloma, Carina |
| safety | all |
| testing/controlling |
| distribution |
| internet | Anthony, Carina, Kristjan |
| marketing | Carina |

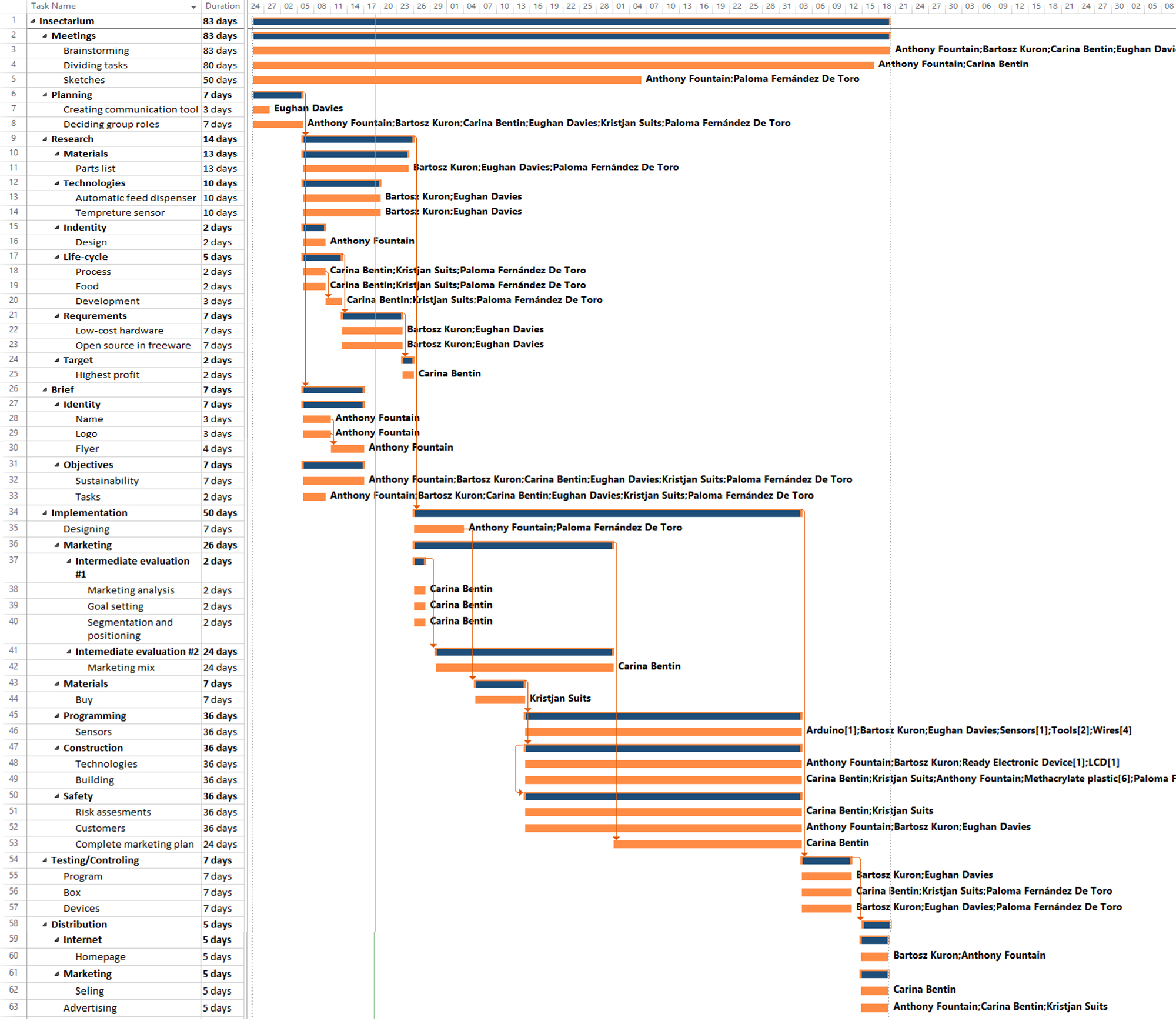

Gantt Chart
WEEK 22/06/2015 - 26/06/2015 GANTT CHART
